Project: Manufacturing Shift Planning

Shift planning against a staffing forecast for American Red Cross

We developed a shift-scheduling application for American Red Cross manufacturing sites. Planners see forecast staffing needs next to scheduled hours for their facility and change the shifts on days that fall short. The forecast comes from a data-science model. We built the scheduling tool that uses it.

What changes for the team

Developed from December 2023 to April 2024

  • 5 monthsof development
  • 5modules built

Why the facilities needed one scheduling tool

Laboratory staffing depends on the work each facility performs, with cryo processing counted in separate hours. The model forecasts demand from scheduled and reported activity.

The planners needed that forecast next to the roster they edit, facility by facility.

Our work

Development of the scheduling web application: a Blazor WebAssembly interface with Telerik UI, ASP.NET Core services with Dapper and an Azure SQL database.

Project details
Client
American Red Cross. Manufacturing and quality-control laboratories that process blood components, such as Baltimore Component and Baltimore QC.
Users
Schedule planners and administrators at each facility. The facility is chosen in the header; user permissions are managed inside the application.
Modules
Overview with forecast against schedule, weekly and monthly schedule, shift editing, baseline staff schedules with alternating weeks, shift templates, activity configuration per laboratory, reports and user permissions.

What changes for the team

For the schedule planner at each facility:

The gap is visible before the week starts

Predicted needs and scheduled staffing are on one chart per facility, for the coming weeks. The planner sees which days fall short.

Forecast and weekly schedule

A recurring pattern is entered once

An employee’s weekday pattern, including alternating weeks, is kept in schedule setup with its effective date. Future weeks follow it without being retyped.

Recurring schedules

Cryo hours are planned beside the roster

The share of each shift given to second-stage cryo is recorded per employee, in the same editor as the hours.

Editing a shift

One tool for every facility

Planners switch facility in the header. Each laboratory has its own shift templates and its own list of activities.

Shifts and facility activities

Two comparisons on one weekly schedule

The daily forecast covers non-cryo work. Cryo work is estimated for the week as a whole, and an employee may give only part of a shift to it.

Each day of the weekly schedule shows non-cryo predicted and scheduled hours and headcount. The footer sets the estimated cryo hours needed for the week against the cryo hours scheduled. The tool shows both gaps, and the planner decides which shifts to change.

Compare predicted and scheduled staffing

Tell us where your staffing forecast comes from and in what units: hours, headcount or volume. We will tell you how we would compare it with a roster day by day.

Forecast and weekly schedule

A planner needs to know whether next week’s roster covers the predicted need at the facility before publishing it.

The weekly schedule has a row per shift and a column per day, with the assigned employees and their hours. A monthly view shows the same schedule over a longer period, and the calendar can be exported.

More screens: Forecast and weekly schedule

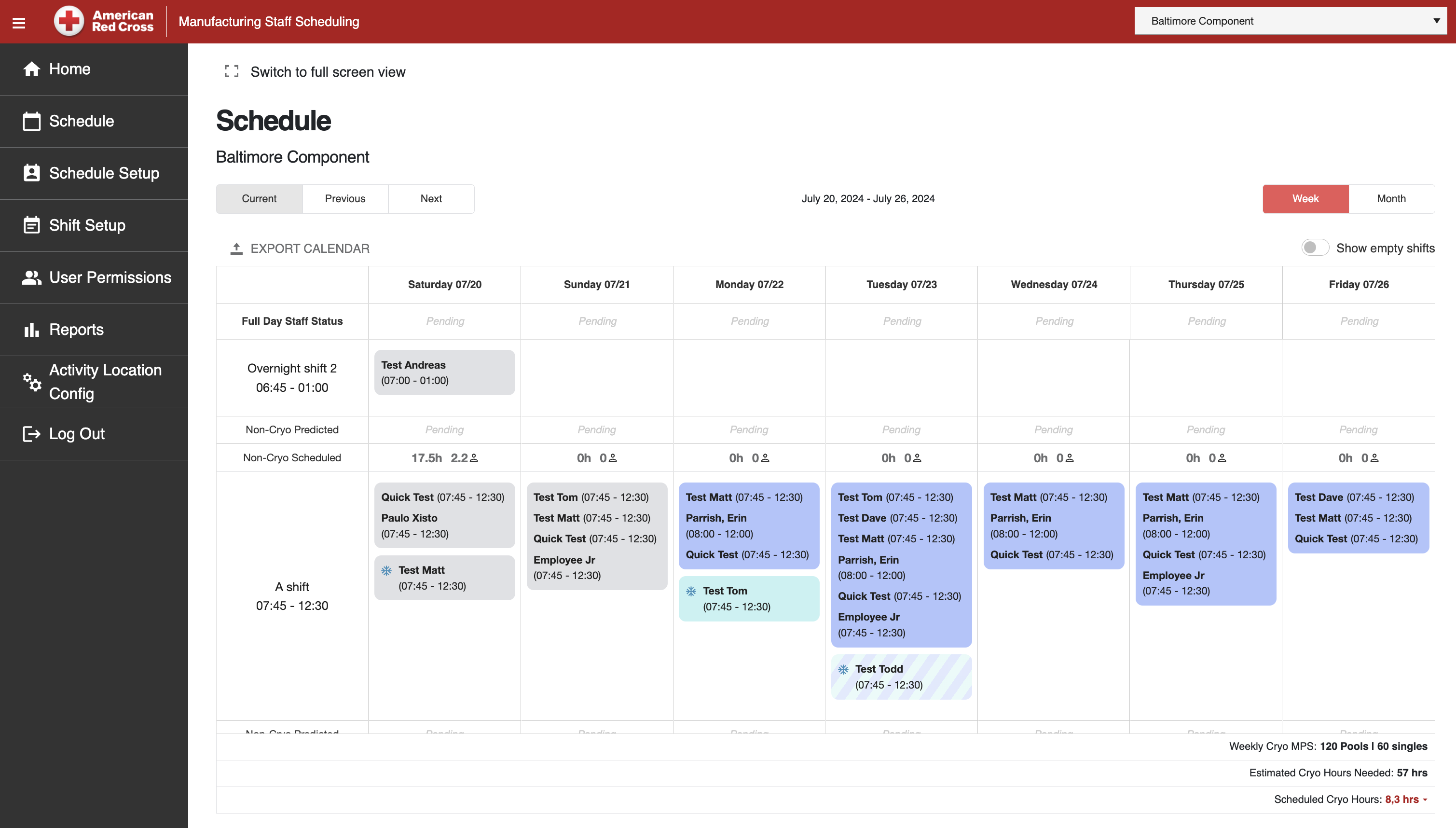

Shift rows list assigned employees and hours by day. Daily staffing totals and separate cryo planning figures accompany the weekly schedule.
Shift rows list assigned employees and hours by day. Daily staffing totals and separate cryo planning figures accompany the weekly schedule.

Editing a shift

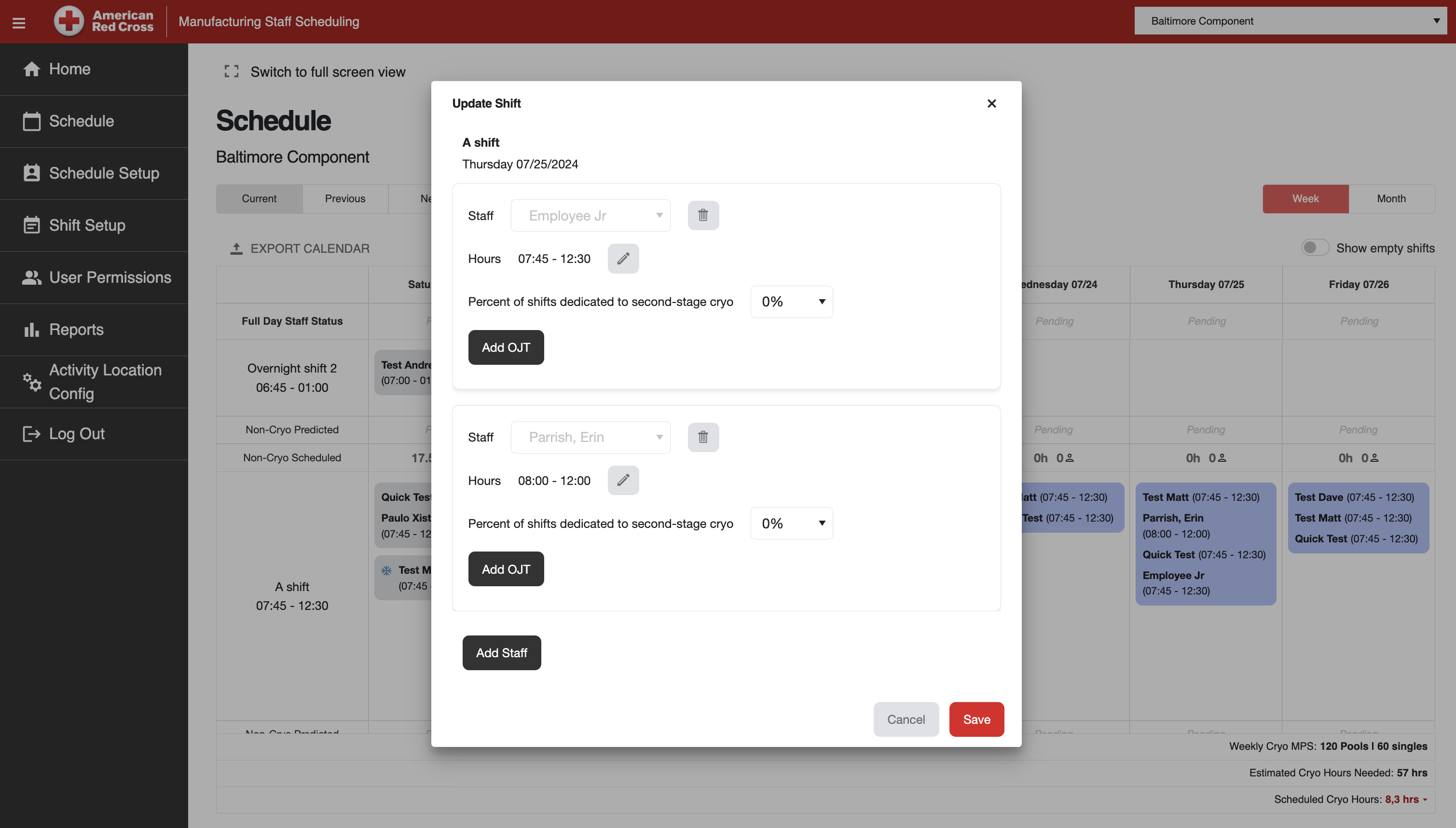

One day is short of staff, or an employee has to leave early. The planner needs to change that shift without touching the recurring pattern.

A shift opens into its staff. The planner adds or removes an employee, edits the hours, sets the share of the shift for second-stage cryo and adds on-the-job training, then saves the day.

Recurring schedules

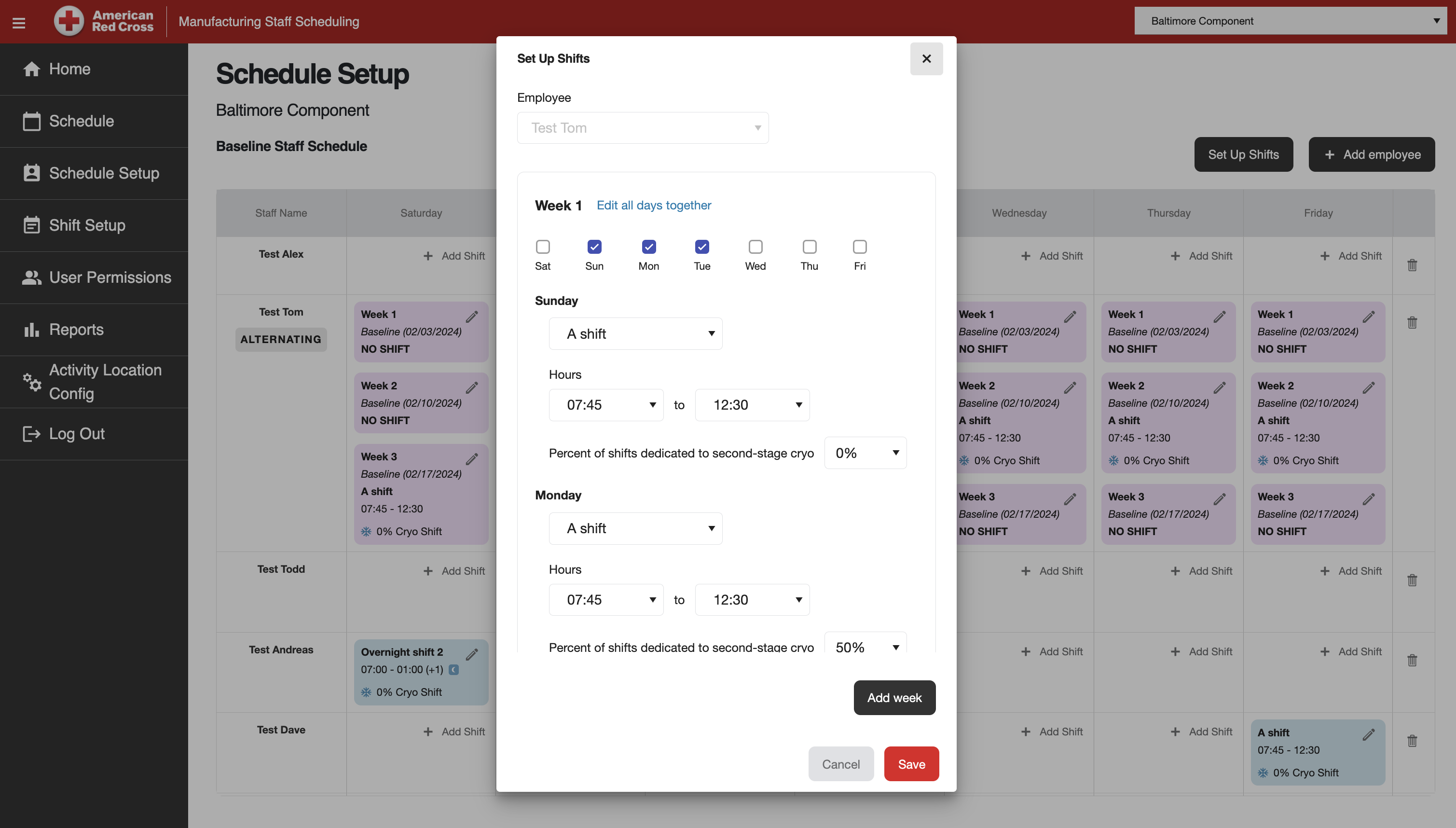

An employee may follow the same weekly pattern or alternate over two or three weeks. The planner needs to record that pattern and the date a change takes effect.

Planners save the recurring shift pattern once, including hours assigned to cryo work. Each version has an effective date. A change to one day can be handled separately in the weekly schedule.

More screens: Recurring schedules
Each week in the employee pattern has its own working days, shift hours and cryo allocation. Another week can be added to the rotation.
Each week in the employee pattern has its own working days, shift hours and cryo allocation. Another week can be added to the rotation.

Shifts and facility activities

Every laboratory performs a different mix of activities and runs its own shifts, including overnight ones.

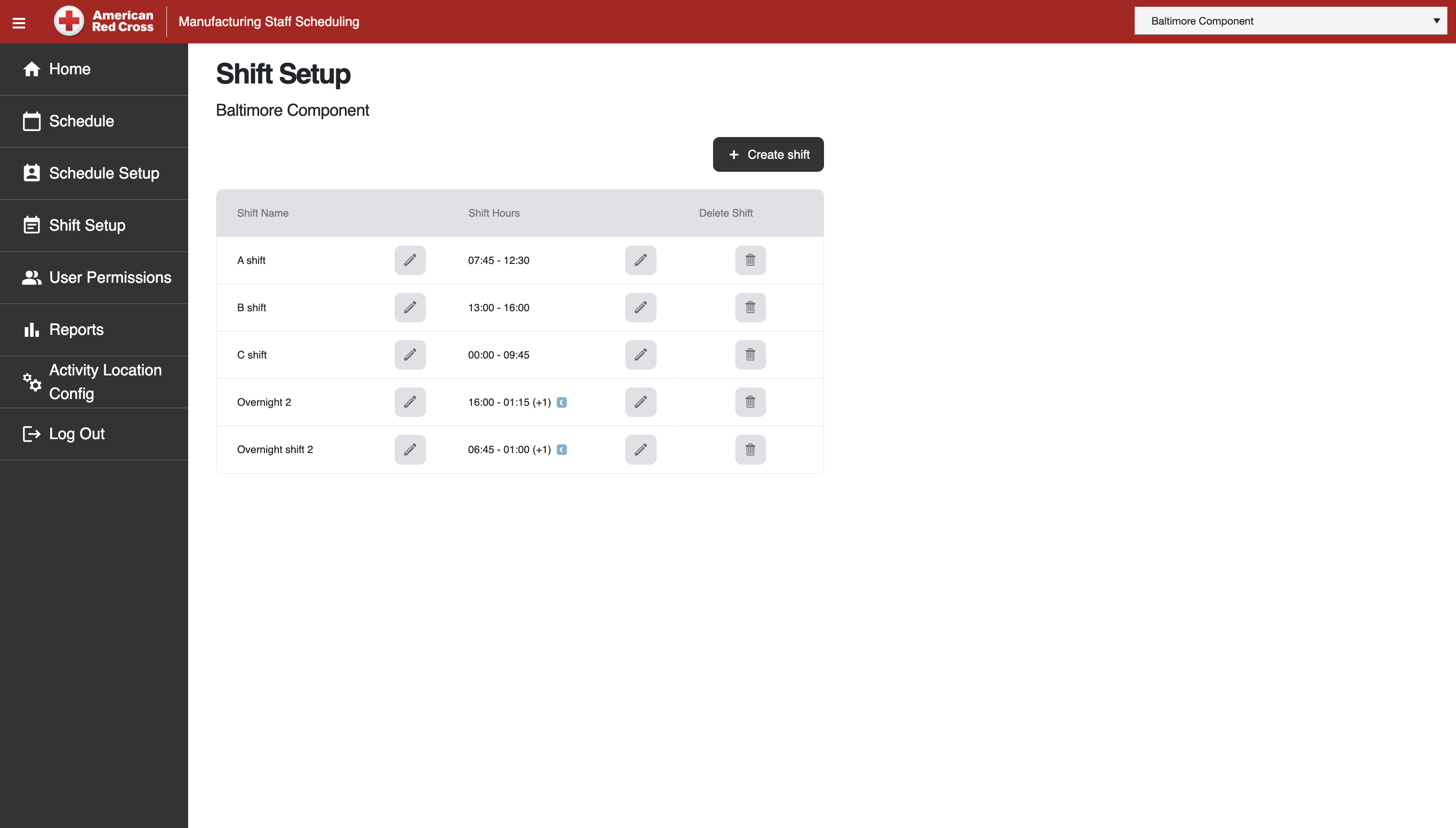

Shift templates define a name and start and end times, with a next-day marker for overnight shifts. The activity table records which functions each laboratory performs, such as QC samples of red cells or platelet testing.

More screens: Shifts and facility activities

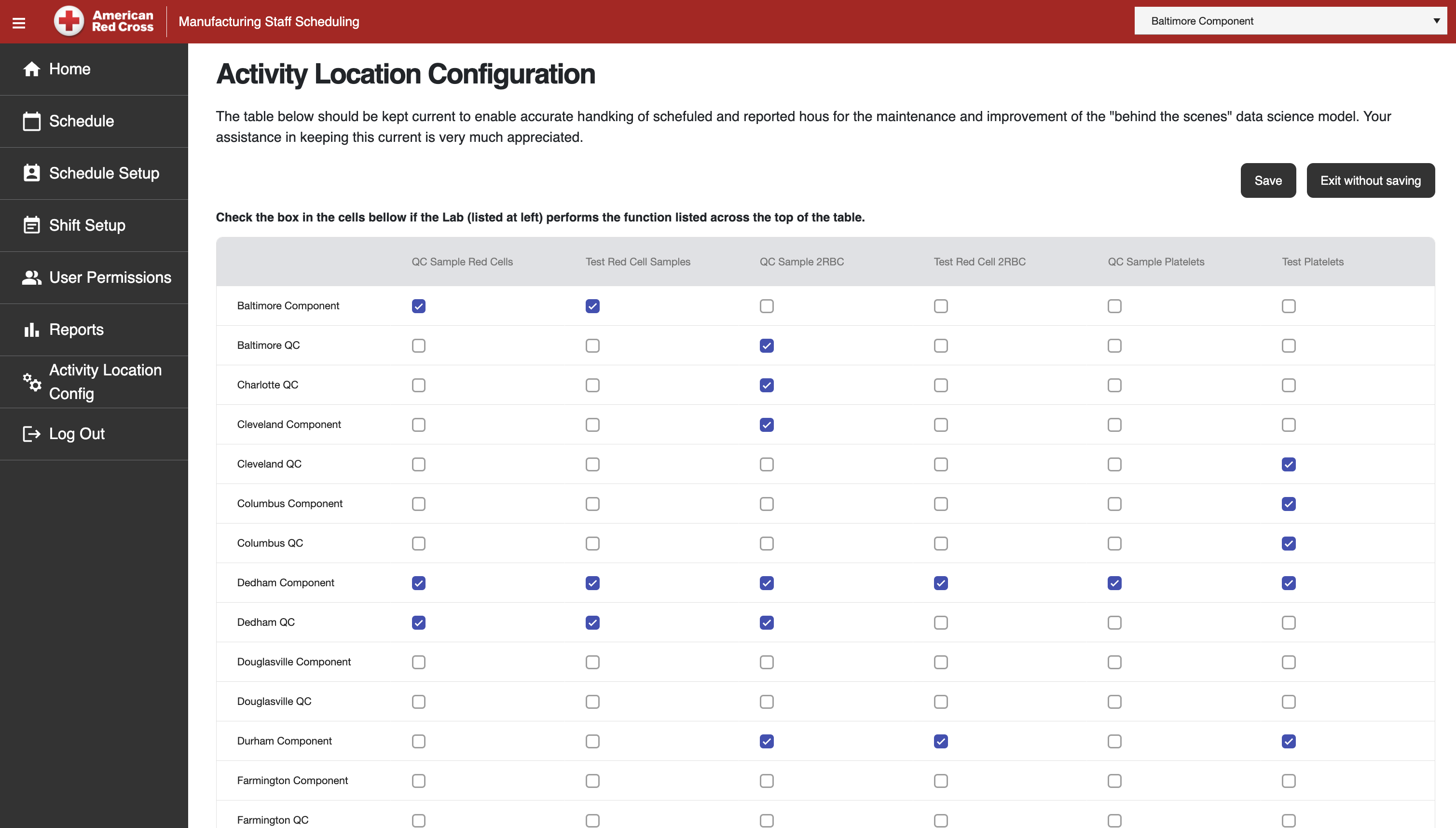

The matrix links locations with manufacturing activities such as sample processing and red-cell or platelet work. These selections provide context for scheduled and reported hours.
Each laboratory, Component or QC, is ticked against the functions it performs: QC samples and tests of red cells, 2RBC and platelets. The screen notes that the table feeds the data-science model.

What we built

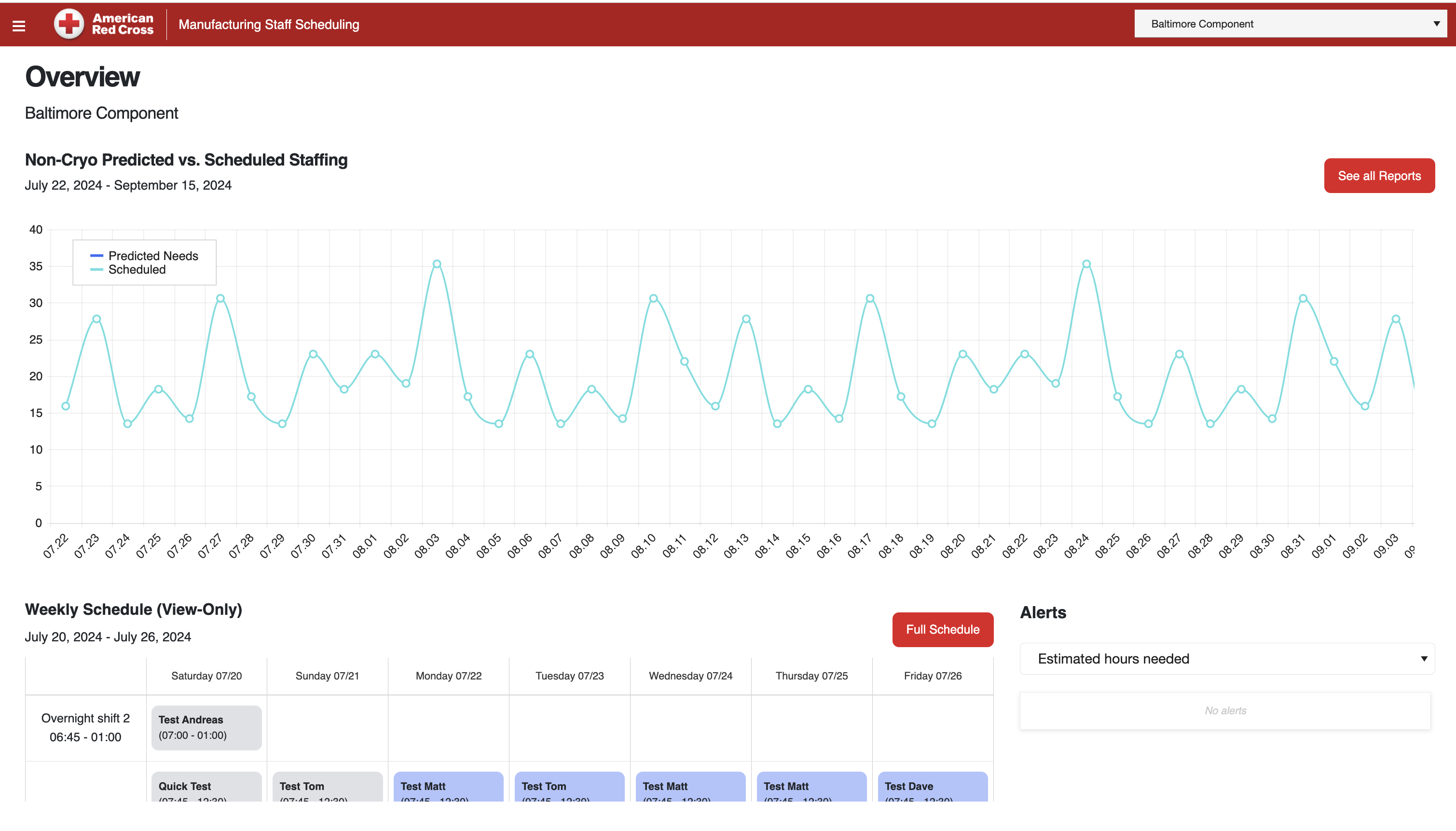

Forecast against schedule

The overview for the selected facility charts predicted needs against scheduled staffing for the coming weeks, with a read-only preview of the current week, a link to the reports and an alerts panel for estimated hours needed.

Weekly and monthly schedule

Shift rows by day with the assigned employees and their hours. Each day shows the non-cryo predicted and scheduled hours and headcount; the footer totals weekly cryo pools and singles, estimated cryo hours needed and scheduled cryo hours. The calendar can be exported, and empty shifts shown or hidden.

Shift editing

A shift on a given day opens into its staff. The planner adds or removes employees, changes the hours, sets the share of the shift given to second-stage cryo and adds on-the-job training.

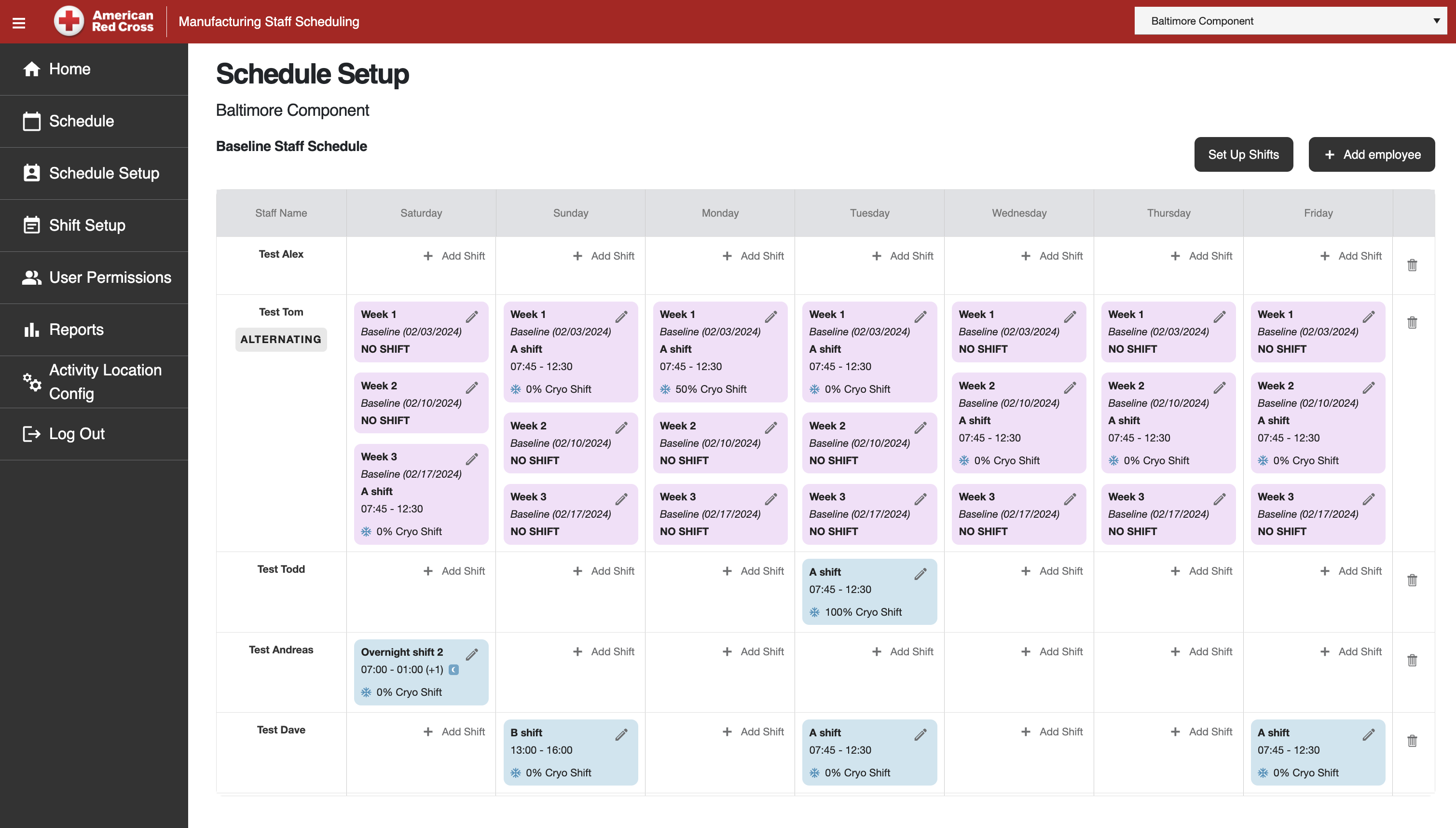

Baseline staff schedules

Each employee has a pattern by weekday with a shift, hours and cryo percentage. A pattern can alternate over two or three weeks, and each version carries the baseline date from which it applies.

Shift templates and activity configuration

Shifts are defined once with a name and start and end times, with a next-day marker for overnight shifts. A table records which functions each laboratory performs, such as QC samples of red cells or platelet testing, and feeds the forecasting model.

Technology behind manufacturing staff scheduling

A browser workspace and .NET services connected to Azure SQL.

Explore the technology and implementation

Scheduling interface

  • Blazor WebAssembly
  • Telerik UI

The scheduling screens are built in Blazor WebAssembly with Telerik UI components.

Application services

  • ASP.NET Core
  • Dapper

ASP.NET Core services, with Dapper for data access.

Cloud and database

  • Azure Services
  • Azure SQL Database

Hosted on Azure, with the data in Azure SQL Database.
